Stantec Broomfield

Home > Projects > Stantec Broomfield
Completed Stantec Broomfield workplace with glazing and built-in work surfaces

Case Study | Commercial Tenant Improvement

23,421 SF. One Complete Workplace.

ASI controlled a complete workplace transition across two levels, connecting furniture decommissioning, architectural construction, building systems, workplace reconfiguration, low voltage, final move-in, and continued support.

View Full Case Study PDF

Completed Broomfield Workplace

Completed Broomfield Workplace

Glazing, built-in work surfaces, finishes, and connected workplace areas delivered through one coordinated program.

23,421 SFTotal work area
TwoConnected levels
90 daysContract window

Overview

Challenge

Transform a 23,421-square-foot workplace across two levels while furniture decommissioning, architectural construction, life safety, mechanical, electrical, technology, finishes, and workplace reset compete for the same field sequence.

ASI Approach

Build one master delivery plan from legacy furniture removal through construction, building systems, low voltage, reorganization, testing, furniture readiness, punch, and clean turnover.

Results

  • 23,421 square feet transformed across two connected levels
  • Decommissioning, rebuild, furniture reconfiguration, and final move-in delivered as one program
  • Low-voltage installation, testing, turnover, and ongoing support coordinated by ASI

Project Info

Client
Stantec
Location
Broomfield, Colorado
Workplace Area
23,421 square feet
Configuration
Two connected levels
Contract Window
90 calendar days
Delivery
End-to-end tenant improvement
Status
Completed

Plans and Project Scale

The Drawings Set the Scope. ASI Connected the Work.

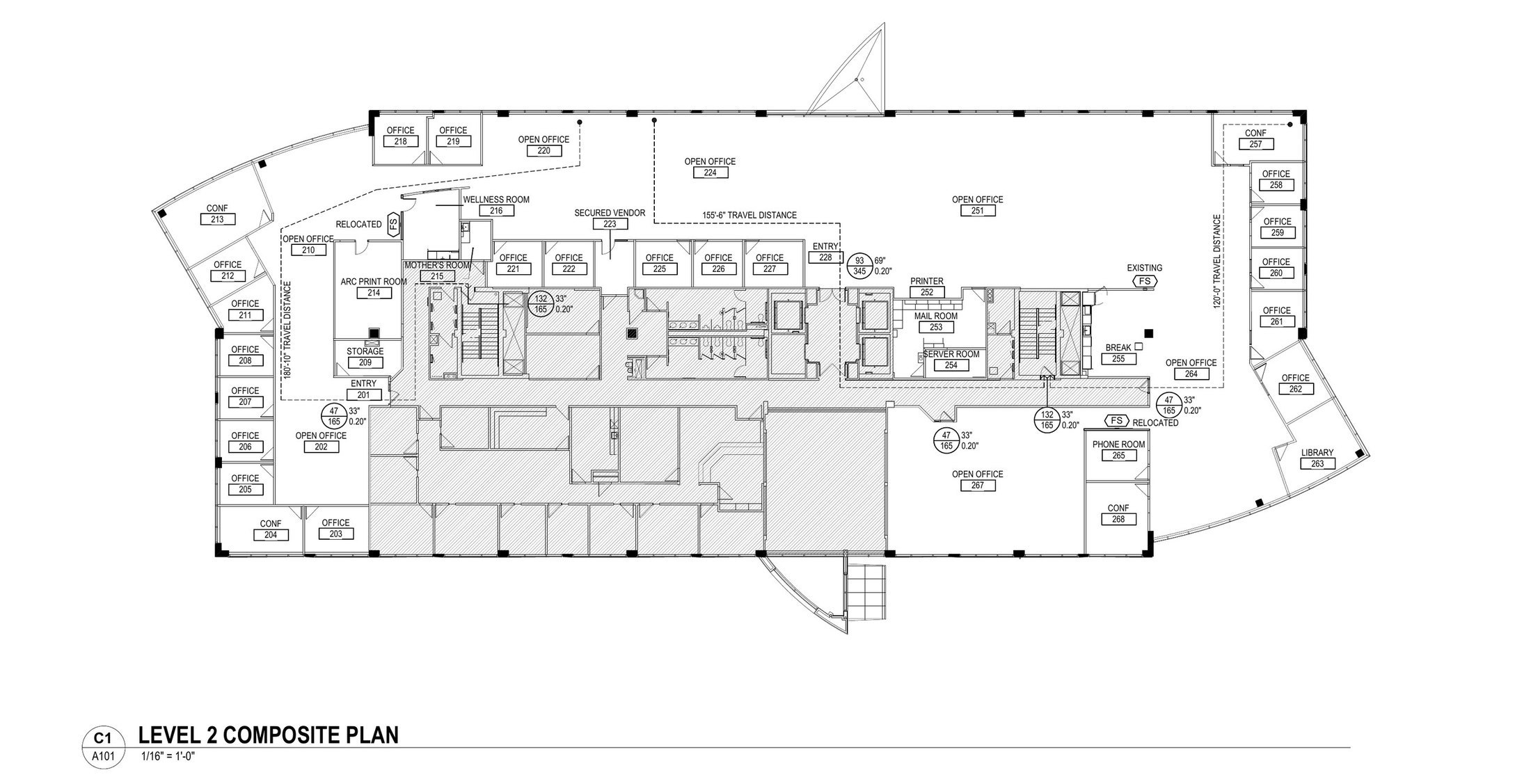

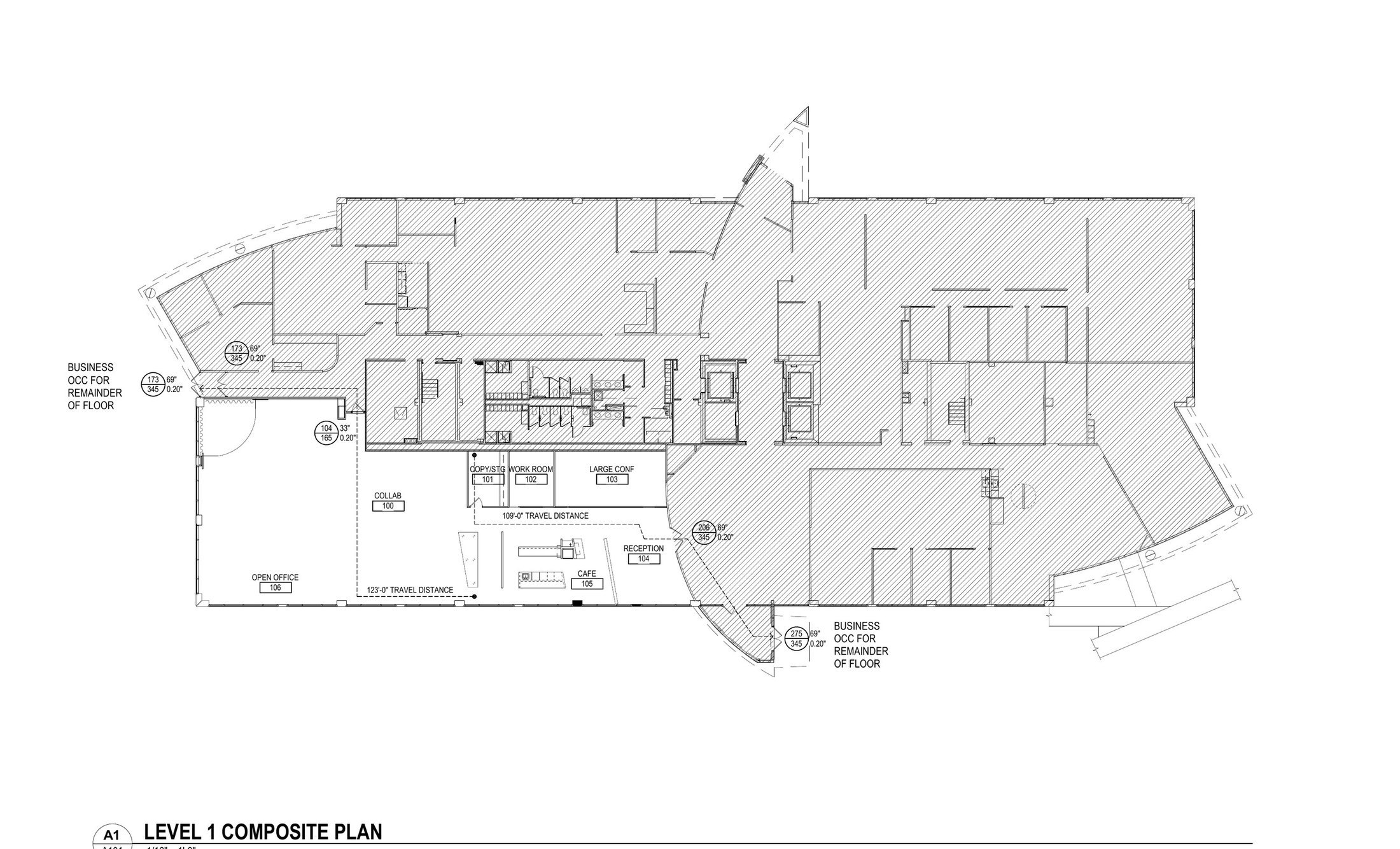

The permitted plan set establishes a 23,421-square-foot program: 5,419 square feet on the first level and 18,002 square feet on the second. ASI connected that footprint to the construction sequence, furniture transition, technology infrastructure, testing, and turnover.

The ASI Approach

Decommission. Rebuild. Reorganize. Reconnect.

The work started with the existing workplace and continued through the rebuilt space, furniture reconfiguration, power, data, technology, final move-in, and ongoing site support.

01DecommissionInventory, protect, disconnect, move, reuse, and route legacy furniture and affected assets so construction can advance with control of what remains.
02BuildCoordinate selective demolition, framing, drywall, millwork, doors, hardware, glazing, ceilings, flooring, sealants, and finishes around the two-level plan.
03IntegrateSequence fire sprinkler, plumbing, HVAC, electrical, lighting, fire alarm, furniture power, conduit, and field-driven revisions with the architectural work.
04ReconfigureAlign new and retained furniture, power feeds, data pathways, workstation changes, technology placement, and the final employee move with the rebuilt workplace.
05VerifyComplete low-voltage installation and testing, field verification, punch correction, cleaning, documentation, operational turnover, and ongoing workplace support.

The Outcome

Two Levels. One Operational Workplace.

ASI brought the architectural rebuild, building systems, furniture reconfiguration, low voltage, testing, final move-in, and closeout into one delivery plan.

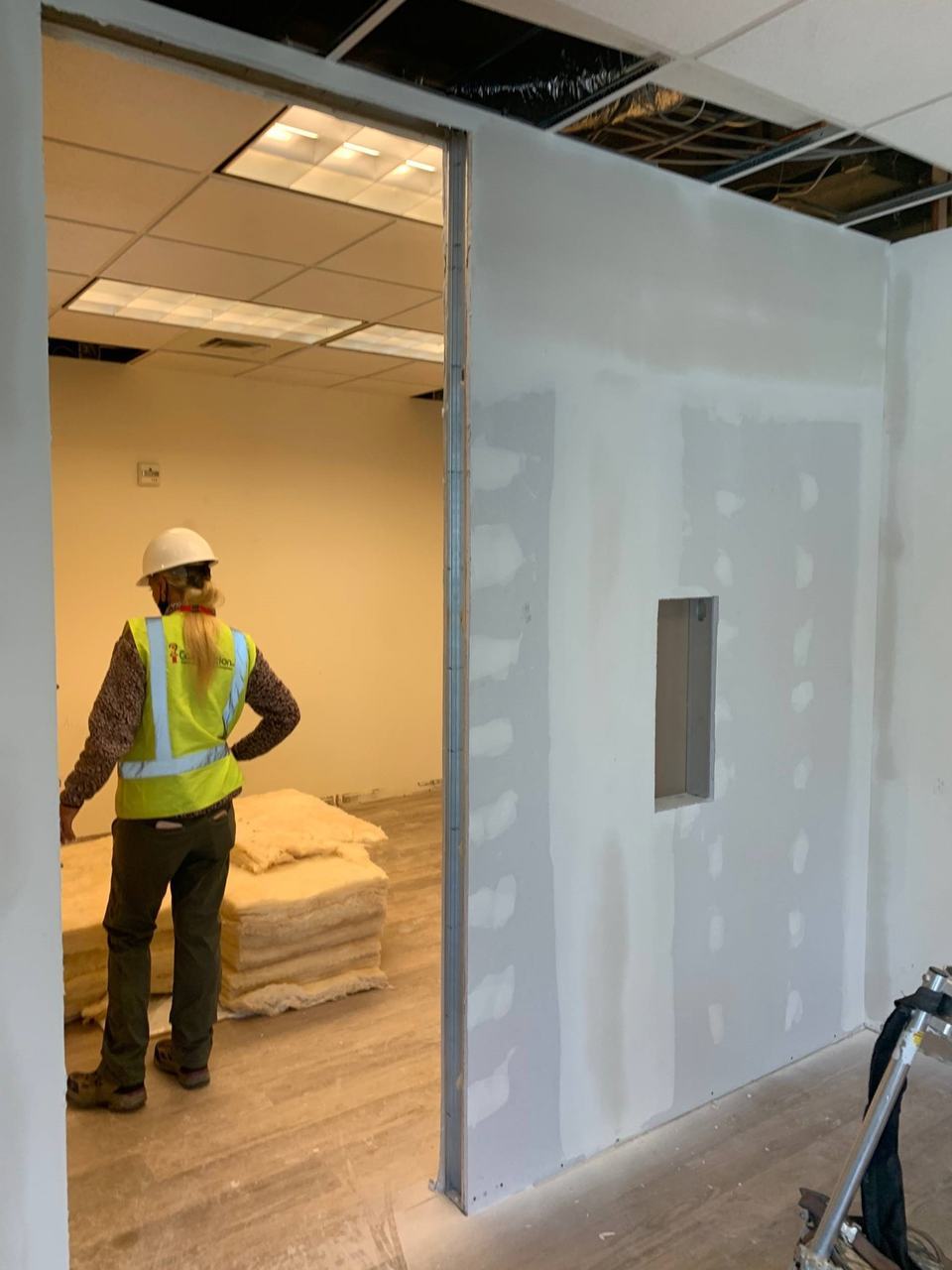

Architectural Construction

Selective demolition, framing, drywall, doors, hardware, glazing, ceilings, millwork, flooring, sealants, and finishes were delivered as one package.

Building Systems

Fire sprinkler, plumbing, HVAC, electrical, lighting, and fire alarm were coordinated around the two-level workplace.

Furniture and Move-In

Decommissioning, reuse, workstation reconfiguration, installation, technology placement, and the final move stayed connected to construction readiness.

Turnover and Support

Low-voltage testing, punch correction, cleaning, documentation, operational turnover, and continued support remained under one accountable team.

Project Details

Built Across Two Levels. Finished as One Workplace.

One Accountable Partner.

From Decommissioning Through Move-In and Support.

ASI managed construction, building systems, furniture, low voltage, testing, move-in, and support as one connected sequence.
