Case Study | Facility Decommission + Closeout

Seven-Day Closeout.
Three-Day Bulk Removal.
Zero Reported Damage.

ASI cleared and restored a 45,000-square-foot Panasonic facility through one controlled plan, even after field volume proved roughly 50 percent greater than anticipated.

View Full Case Study PDF


Cover of the Panasonic facility decommission and closeout case study

45,000Square feet cleared and restored
7 DaysFull engagement from site walk through turnover
3 DaysBulk material removal

Overview

Challenge

A compressed lease transition left one shared elevator for concurrent move and decommission activity. The facility also contained approximately 50 percent more material than the initial estimate.

ASI Approach

Validate the field condition, expand hauling capacity, coordinate material flow around shared access, recover usable furniture value, complete restoration work, and carry the facility through final review.

Results

  • Bulk removal completed in three days within a seven-day full engagement
  • Finished ahead of schedule and on budget
  • Zero reported facility damage or incidents

Project Info

Project Partner
Cumming
End Client
Panasonic
Project Type
Accelerated facility decommission
Facility
45,000 square feet
Full Engagement
Seven days
Bulk Removal
Three days
Delivery
Ahead of schedule, on budget

The ASI Approach

From Site Walk to Turnover.
Seven Controlled Days.

As the scope expanded, ASI adjusted resources and sequencing while preserving the access, hauling, restoration, recovery, and safety controls required for closeout.

01SurveyValidate access, material volume, restoration needs, specialty items, and turnover requirements across the facility.
02MobilizeSecure field crews, added hauling capacity, equipment, containers, and recovery partners for the compressed schedule.
03SequenceCoordinate decommission activity with the relocation team around one shared elevator and a single access path.

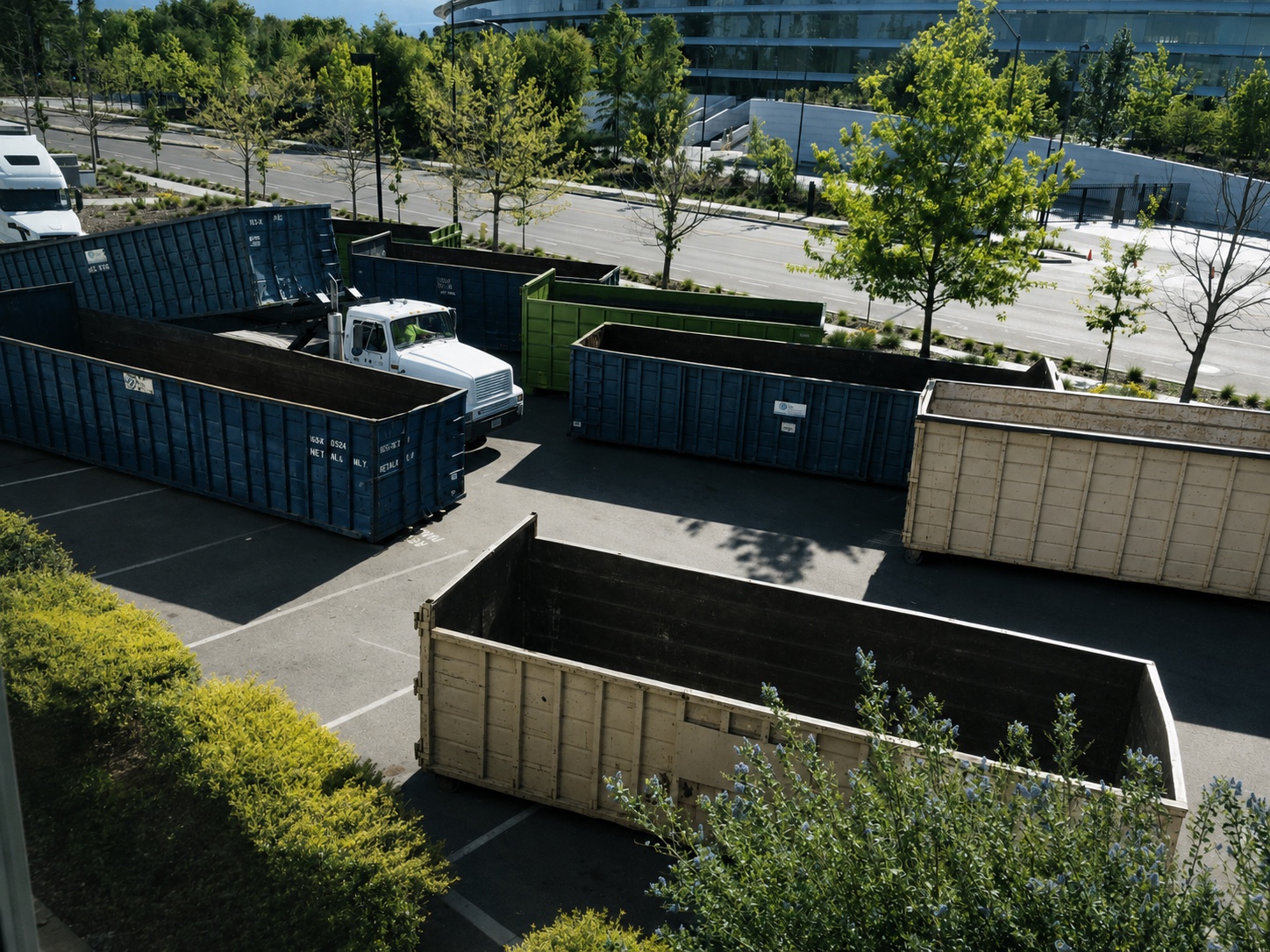

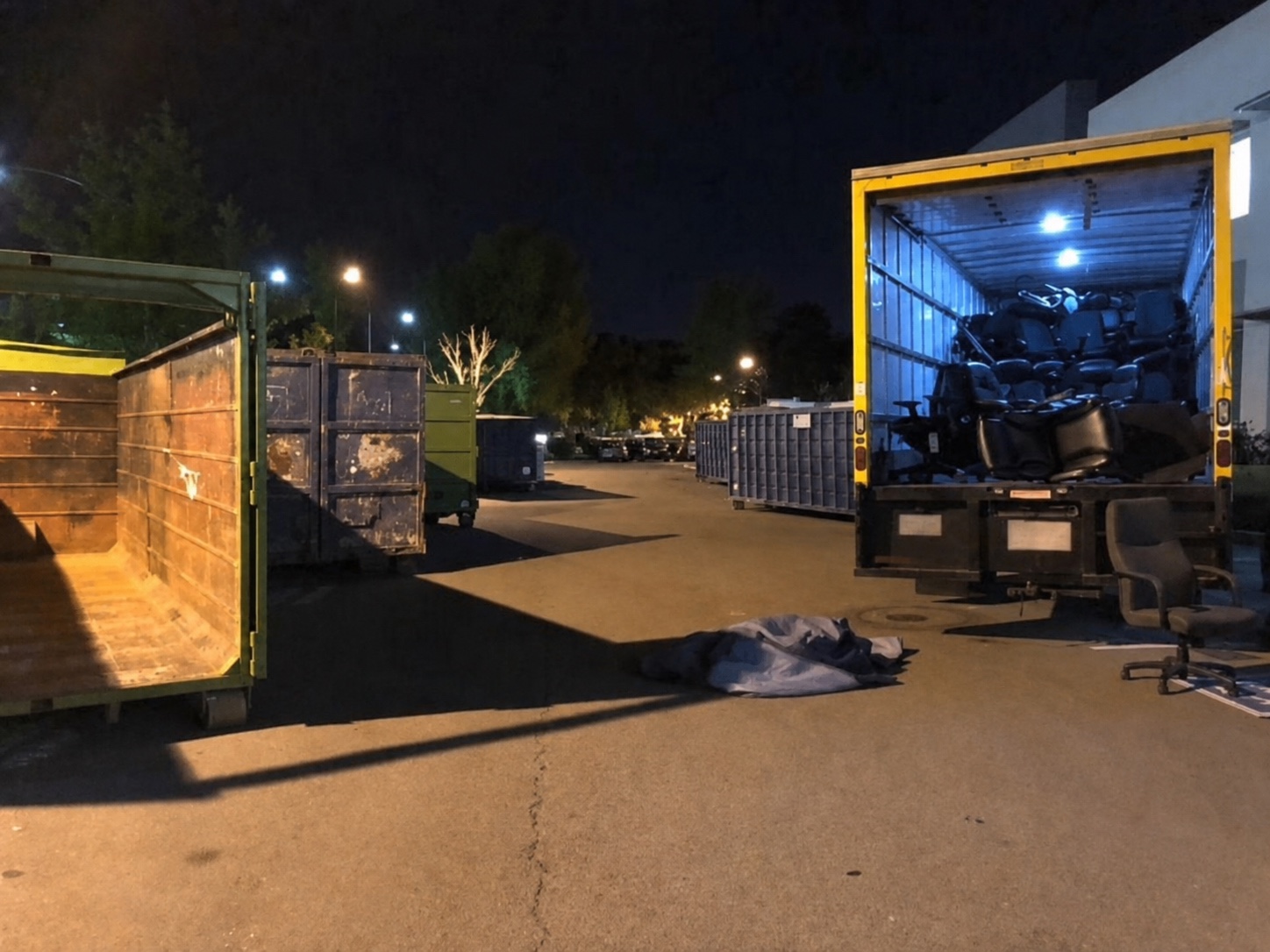

04ClearMove furniture, equipment, specialty material, and recycling through 27 truckloads while protecting the facility.
05CloseComplete patch and paint, IDF rack removal, cleanup, final review, and documented turnover.

The Outcome

27 Truckloads Removed.
Value Recovered.
Facility Released Early.

The expanded scope was absorbed without extending the deadline or losing control of final condition.

Schedule Recovered

Added hauling resources and revised sequencing kept the larger field volume from extending the deadline.

Material Value Returned

Furniture resale returned a $13,000 credit, while more than 70,000 pounds of metal were separated for recycling.

Broader Scope Absorbed

Patch and paint, IDF rack removal, and specialty-disposal coordination were integrated into the field plan.

Clean Turnover

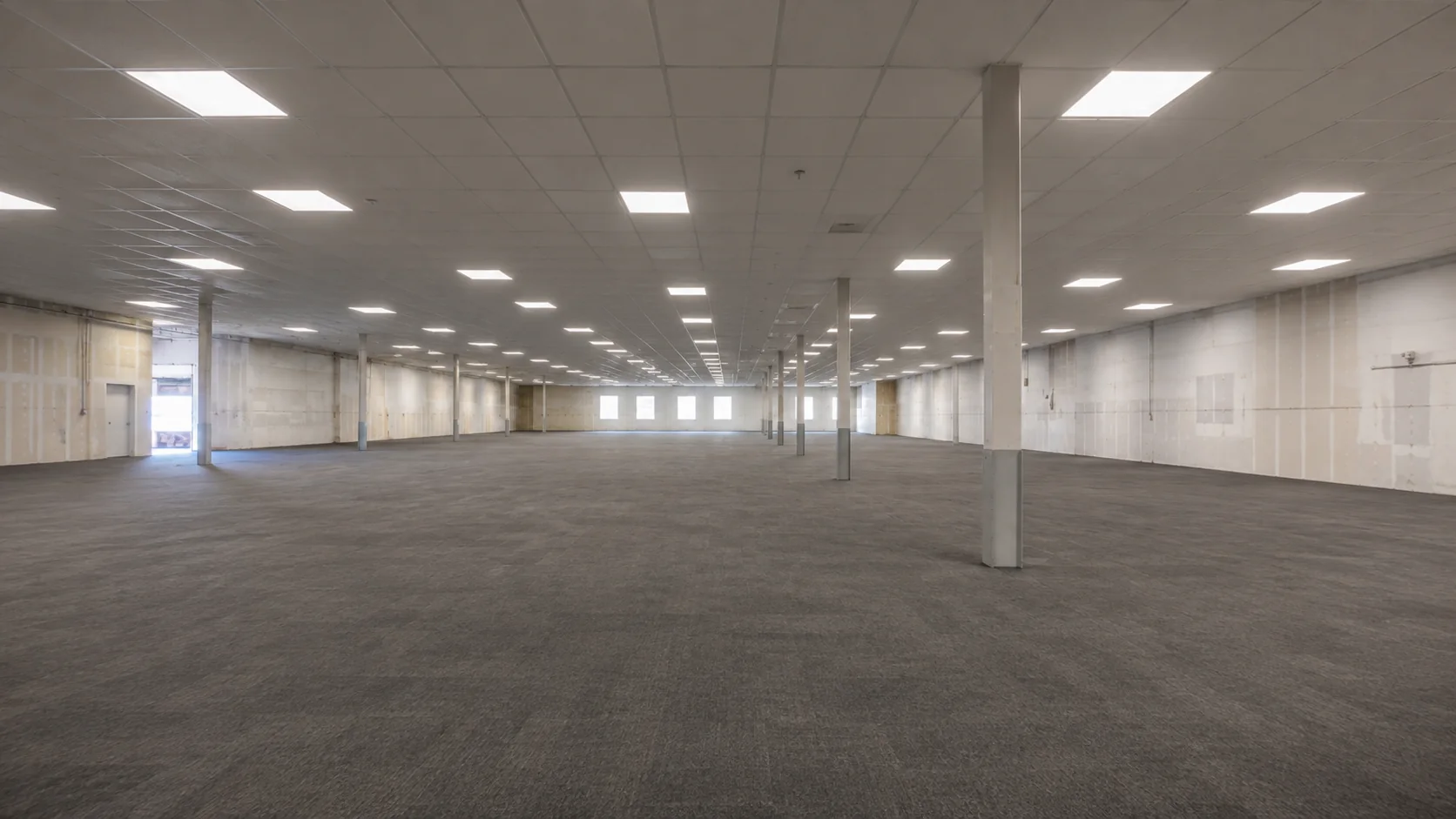

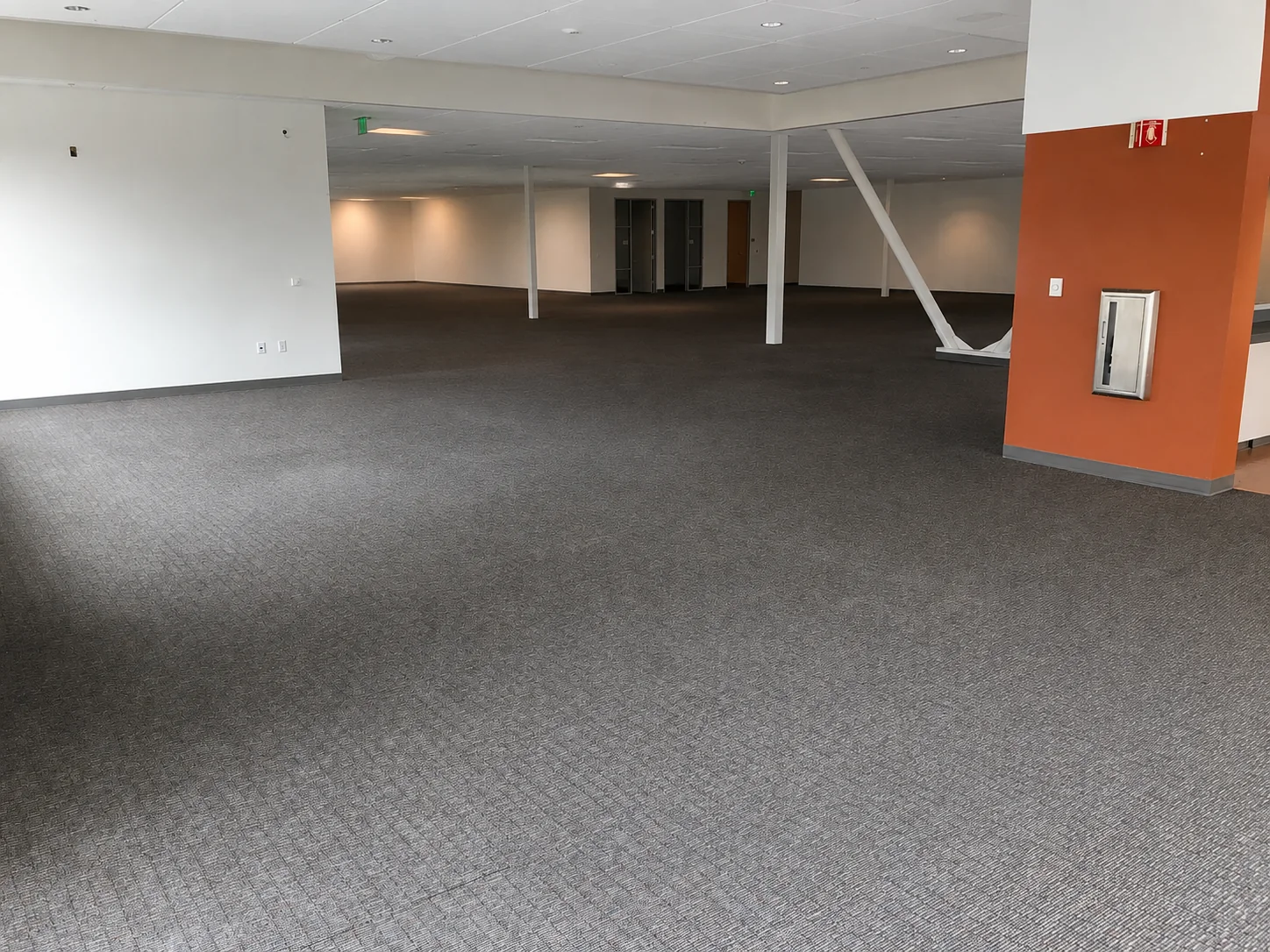

The facility reached final review ahead of schedule, on budget, and with zero reported damage.

Accelerated Closeout

The project combined high-volume material movement with closeout work that preserved the ceilings, carpet, and finished interior condition.

Project Partner Feedback

“In spite of the delays and expanded scope, ASI finished ahead of schedule, on budget, and with zero damage to the facility.”

Loren Smith
Senior Director, Cumming

One Accountable Partner. Nationwide.

From Plan to Closeout.

ASI manages accelerated decommissions, material recovery, restoration, hauling, specialty coordination, and turnover through one accountable plan.
