Built production-set structure at the AwesomenessTV and Viacom Canoga Park studio

Case Study | Accelerated Studio Closeout

14 Days. Three Production Sets. One Clean Handoff.

ASI coordinated production-set demolition, building-system disconnections, debris logistics, restoration, and landlord punch work across a three-building Canoga Park studio exit.

View Full Case Study PDF

Built production-set walls and ceiling structure at the Canoga Park studio

A Building Within the Building

Complete production interiors had to be dismantled while protecting the landlord’s retained space and systems.

14 daysFixed exit window
Three setsAcross three buildings
88 containers40-yard roll-offs coordinated

Overview

Challenge

The client had two weeks to return a three-building production operation. The sets included walls, ceilings, flooring, lighting, electrical, low voltage, HVAC distribution, glass, stairs, private rooms, and stored material. Landlord restoration and correction items continued to grow without moving the deadline.

ASI Approach

ASI sequenced demolition and utility removal together, coordinated forklifts and container exchanges, documented newly identified landlord requirements, and folded each item into the field schedule and turnover plan.

Results

  • Three production sets dismantled through one accelerated exit plan
  • Eighty-eight 40-yard containers coordinated as removal volume expanded
  • Building systems, restoration, landlord punch work, and handback carried through closeout

Project Info

ClientAwesomenessTV and Viacom

LocationCanoga Park, CA

ProgramThree sets across three buildings

Schedule14-day exit window

DeliveryStudio decommissioning, restoration, and lease handback

StatusCompleted

See the Execution

Watch the Set Come Down.

Walls, ceilings, and a complete built environment came apart through a coordinated field sequence. See the work in ASI’s studio-removal film.

The ASI Approach

The Scope Kept Evolving. The Deadline Did Not.

New landlord requirements were assessed, resourced, and sequenced into the same 14-day exit plan. Demolition, removal, restoration, and punch work remained connected as conditions changed.

01Dismantle

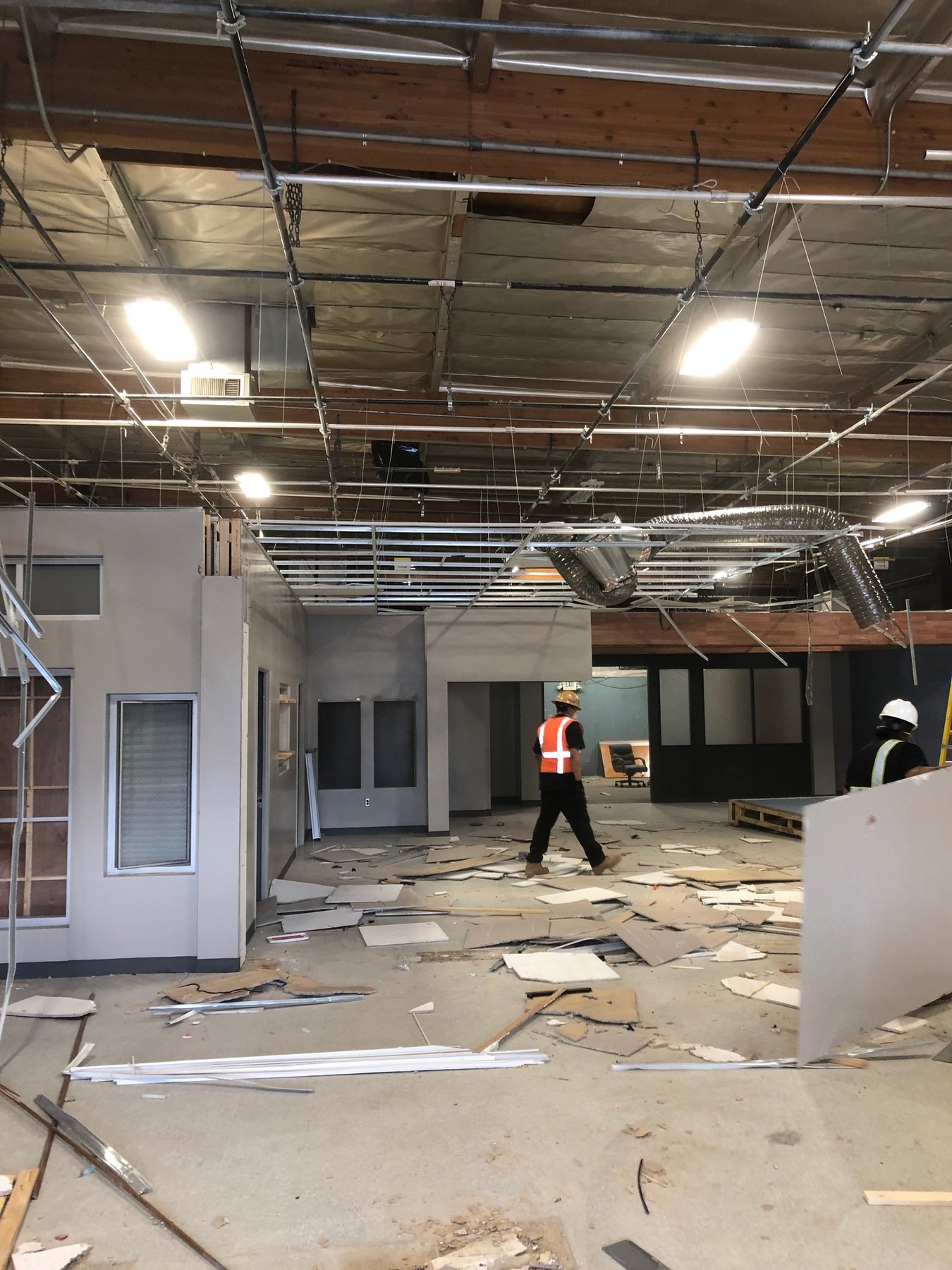

Remove built set walls, private rooms, ceilings, flooring, speed rail, glass sections, stairs, props, furniture, and surrounding material while protecting retained building conditions.

02Disconnect

Coordinate set power, lighting, low-voltage cabling, HVAC distribution, fire-control components, and affected electrical corrections with the demolition sequence.

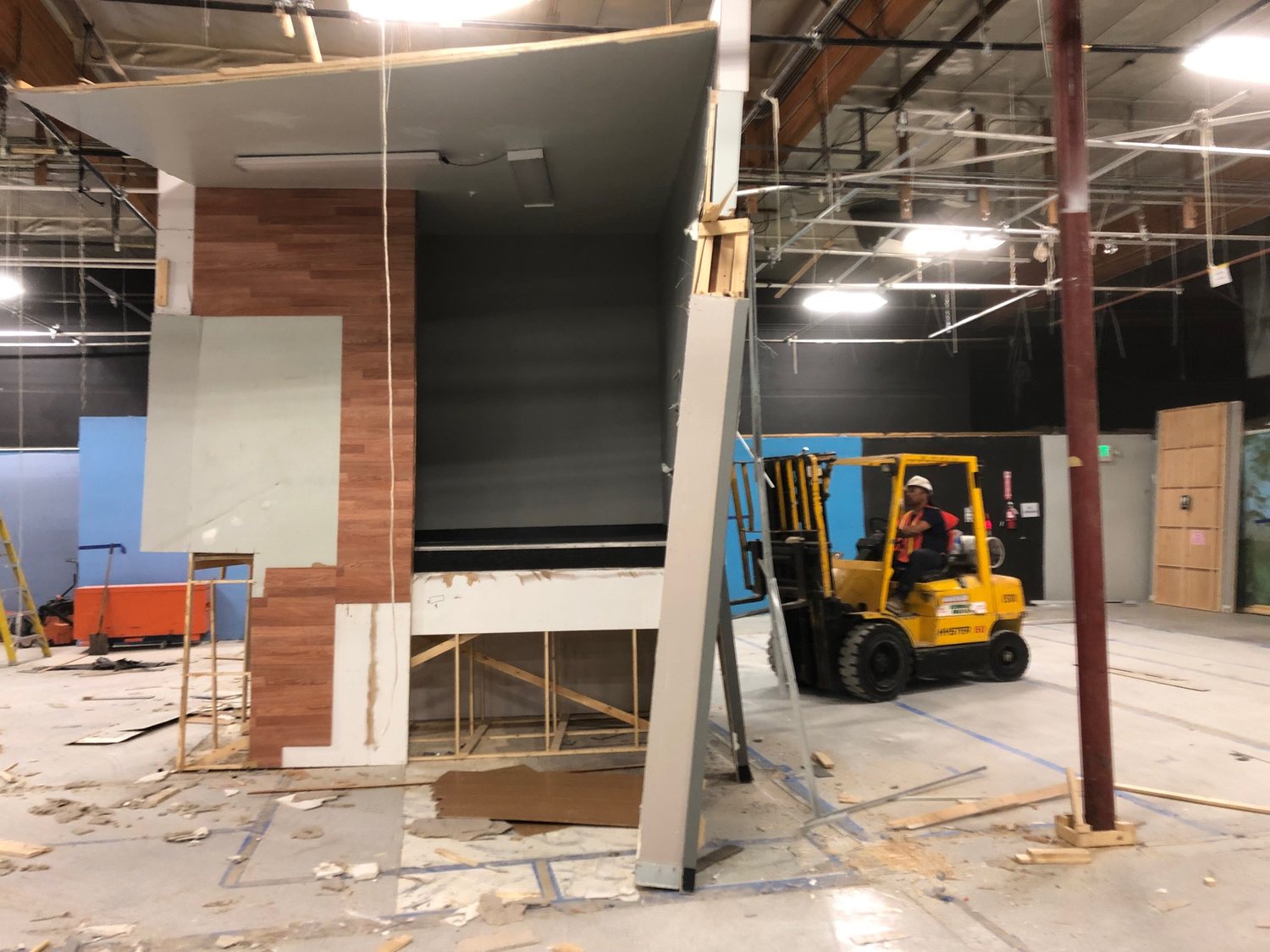

03Haul

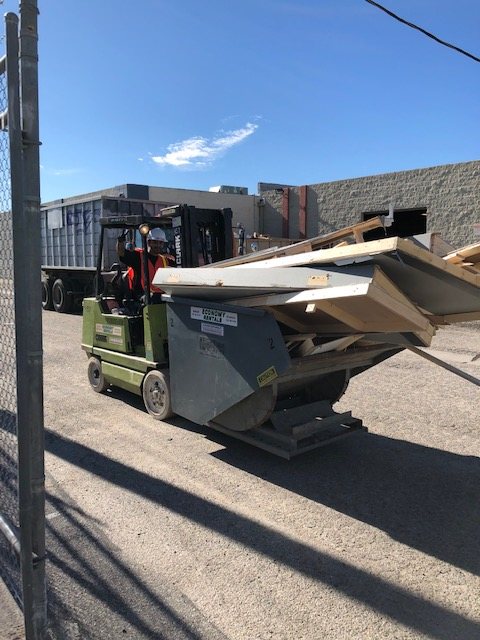

Keep forklifts, floor-removal equipment, material handling, metal recovery, and container exchanges aligned with crew progress. Eighty-eight 40-yard roll-offs supported the expanded removal volume.

04Restore

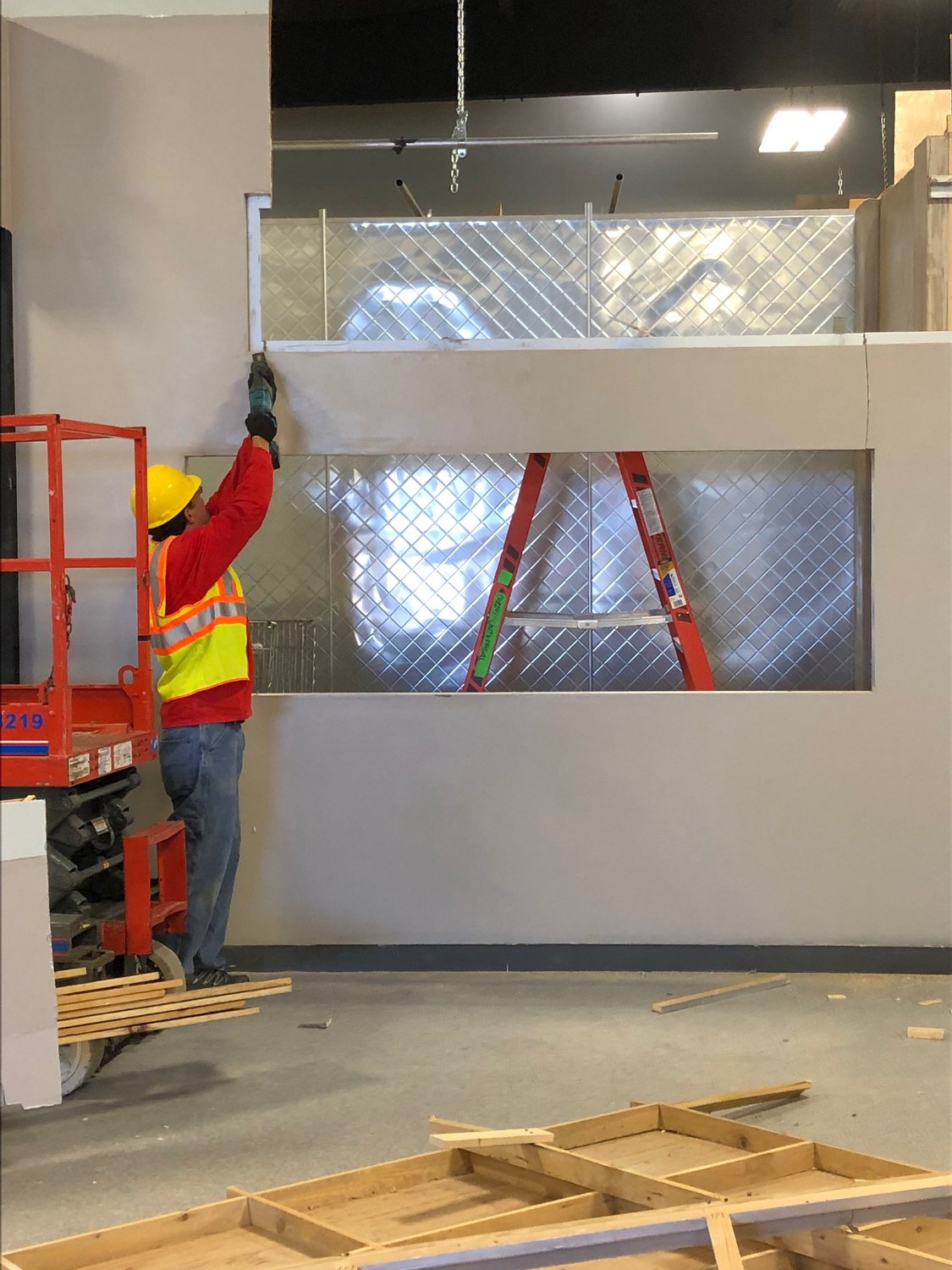

Scrape and clean floors, patch walls, complete 6,850 square feet of deck-to-deck painting, restore glass framing and bronze glass, and address the surrounding areas required for handback.

05Close Out

Carry newly identified mesh, paneling, sound-wall, cleaning, glass, painting, electrical, and exterior patching requirements into landlord walkthroughs, punch work, and final turnover documentation.

The Outcome

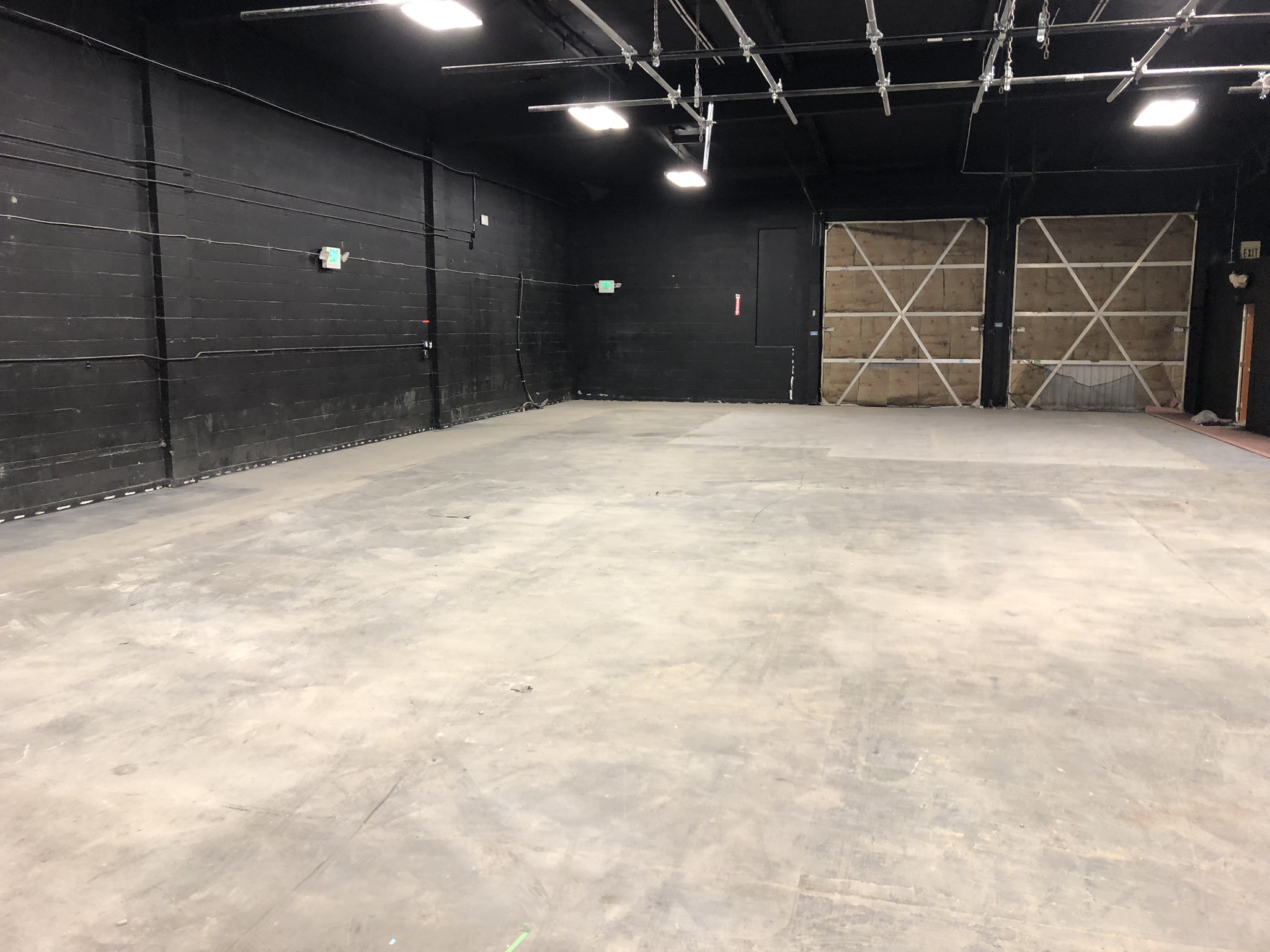

The Sets Disappeared. The Deadline Held.

ASI connected studio demolition, building-system disconnections, heavy debris logistics, restoration, and rolling landlord requirements under one handback schedule.

Production Environments Dismantled

Complete built sets and their associated materials were removed through coordinated multi-trade execution.

Landlord Scope Brought Under Control

Newly identified work was assessed and folded into the same field plan as crews advanced.

Removal Capacity Kept Pace

Equipment and container exchanges supported the growing volume without separating logistics from the construction schedule.

Restoration Carried to Handback

Floors, walls, glass, painting, patching, cleaning, and final punch remained part of ASI’s closeout responsibility.

A Studio Exit With No Room for Delay.

Explore the full project scope, field sequence, photographs, and results in the five-page case study.
